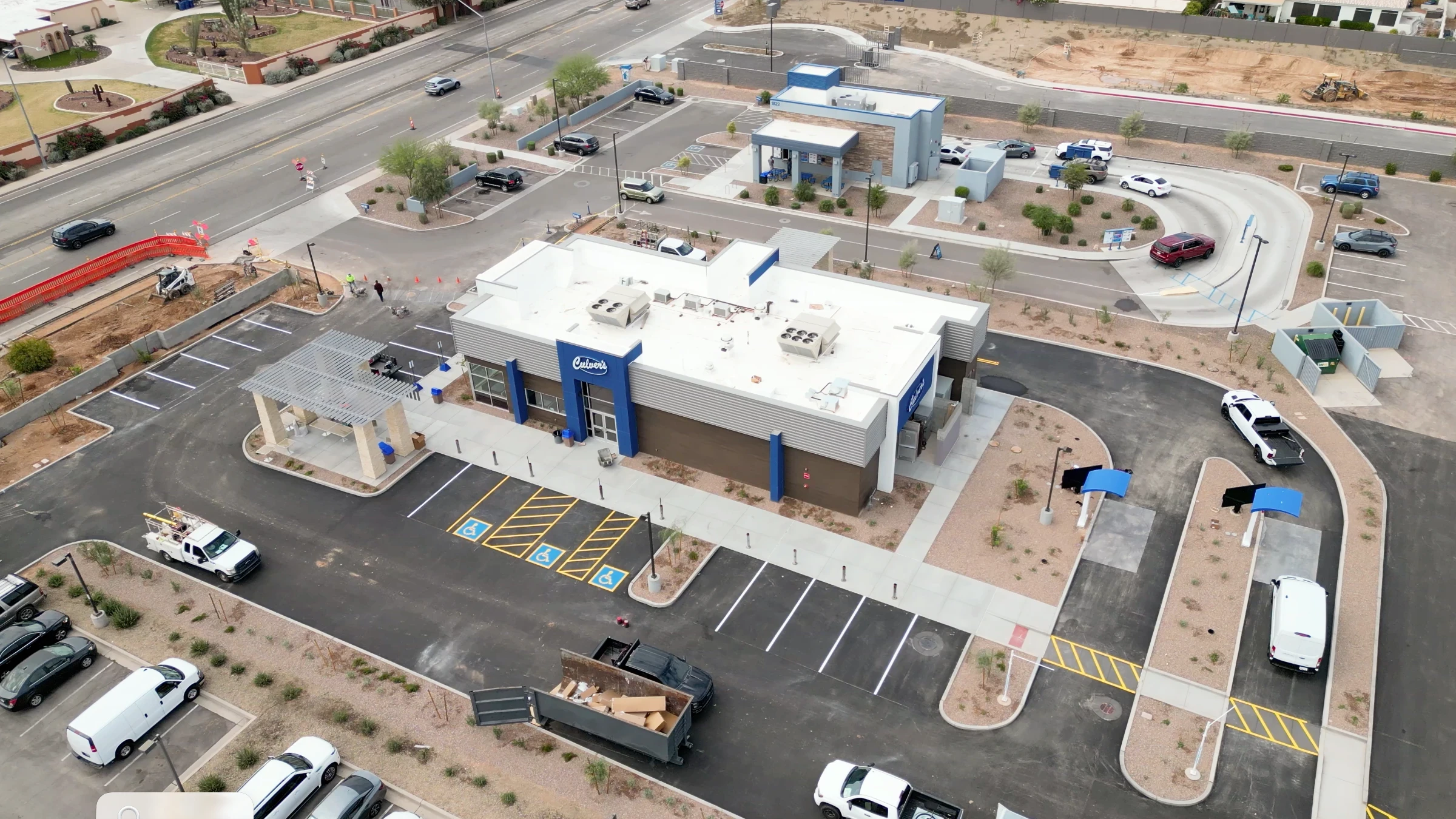

Finished Culver's restaurant in Mesa, AZ with new paved parking lot and drive-thru
Project — Mesa, AZ

Culver's Mesa

Full site work for a new Culver's drive-thru. Demo, building pad, grading, base and paving, all done while the neighbors stayed open for business.

Location
Mesa, AZ
Project Type
Commercial Restaurant
Our Scope
Site Prep, Pad & Paving
Timeline
Sep 2025 – Apr 2026

Pad to Pavement

The GC needed a crew on short notice. We showed up and stuck with it through rain, utility conflicts and a crowded site.
01 / Demo

Demo & Clearing

Tree removal, saw cutting, and demo of old asphalt, concrete, curb and light poles, kept separate for proper disposal.

02 / Pad

Building Pad Over-Ex

Over-excavated the building pad 3 ft, got it verified, then backfilled and compacted in lifts.

03 / Grading

Site Grading

GPS machine control ran the cuts and fills. Good dirt got hauled to another job as pad fill instead of the landfill.

04 / Curb Grade

Curb & Flatwork Grade

Cut curb, sidewalk, drive-thru and landscape island grades ahead of the concrete crew to keep the schedule moving.

05 / Base

ABC Base Course

About 1,600 tons of ABC placed and compacted to a 6 in. section, then tested before paving.

06 / Paving

Paving & Closeout

Asphalt paving, patching, crack seal and striping touch-ups, then walked the punch list with the owner until it was done.

The Building Pad

Everything on this site sits on the pad, so that's where we started.
Over-Excavation

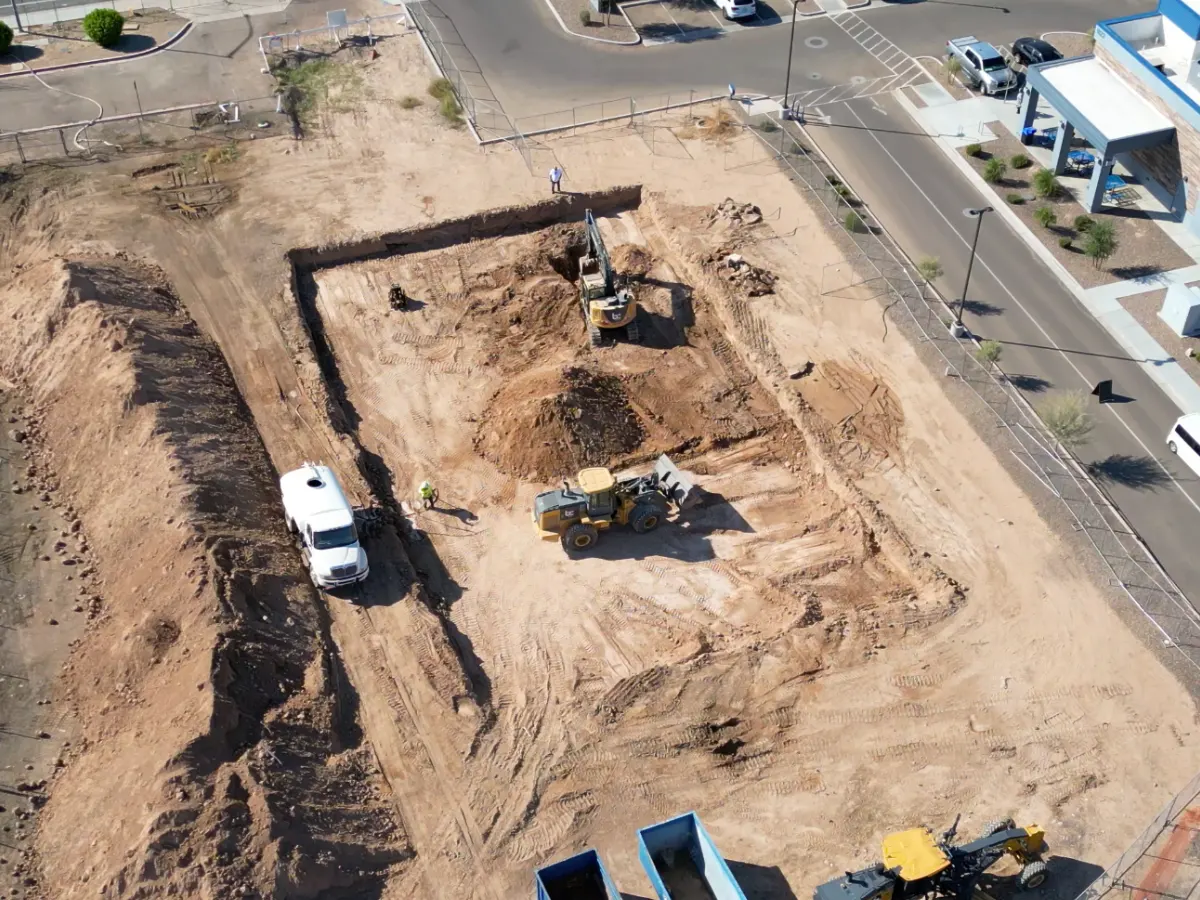

Building pad over-excavation at the Culver's Mesa site

Pad over-ex: 3 ft down corner to corner with a 5 ft blowout, checked by laser. Along the way we uncovered an abandoned interceptor about 8 ft deep.

Finished Pad

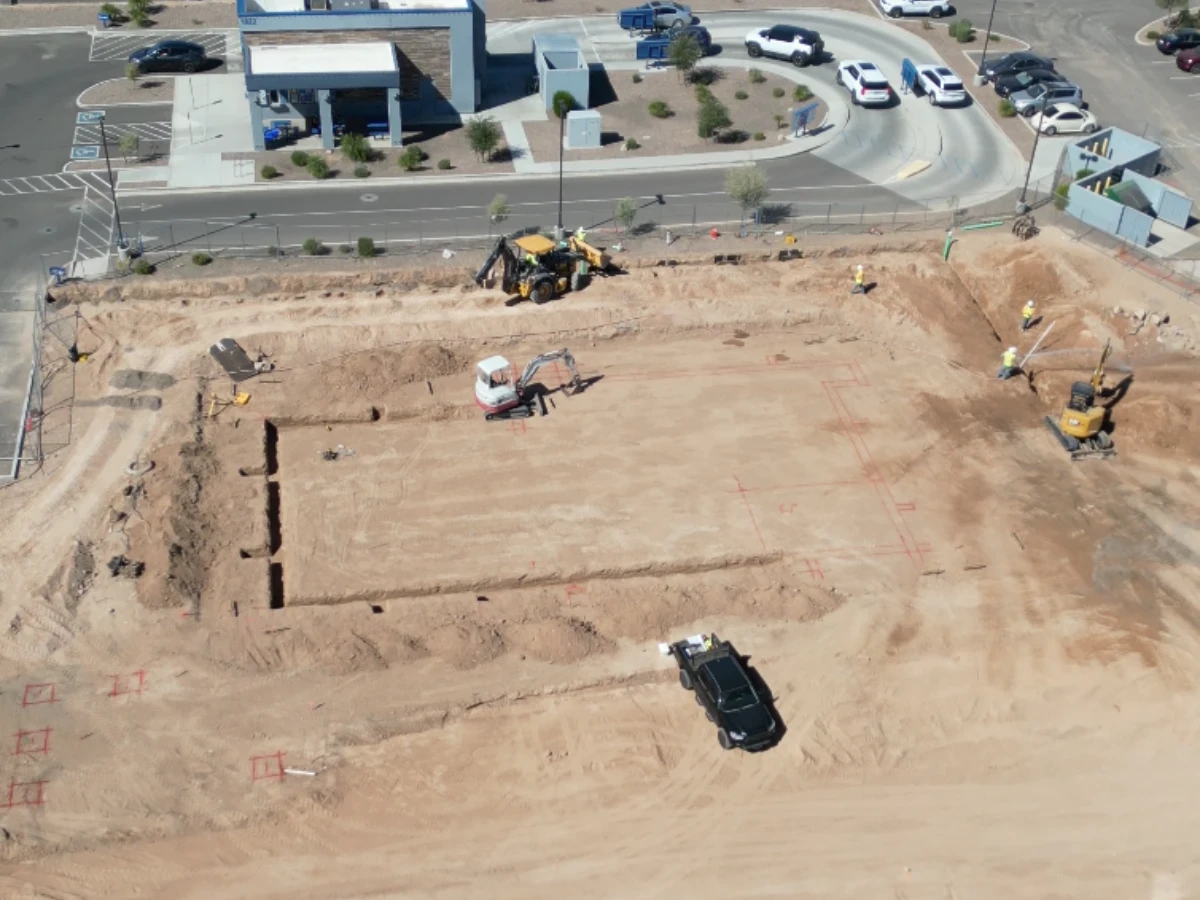

Finished Culver's building pad with foundation footings being dug

Verified, then rebuilt in compacted lifts to 8 in. below finish floor. Here the footings are going in for the foundation.

From the Operator's Seat

How the Earthwork Gets Done

Sean ran the blade on this job. He walks through our earthwork process — digging out the pad, moisture, compaction and grade — and why each step matters for what gets built on top.

From the Superintendent

Chuck ran this site day to day. Here's what it was like working with our crew.

Chuck

Project Superintendent

Start to Pave-Ready

A Busy Site That Never Shut Down

Dutch Bros and Outback next door stayed open the whole time. We built a rock access road to keep their customers and trash pickup moving, worked around the other trades, and kept grading through a wet winter.

Grade was set with GPS machine control and every layer went through compaction testing before the next one went down.

3 ft
Pad over-excavation
1,600 t
ABC imported
GPS
Machine-controlled grade
Final Surface

The Paving Process

Once the base passed testing, asphalt went down across the drives, stalls and drive-thru lane. We came back for patching, crack seal and striping touch-ups until the punch list was closed.
